ICT504 IT Project Management
- Subject Code :
ICT504
- Country :
Australia
Weekly Activity – 4
Answer the Following Questions

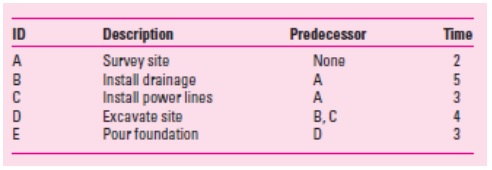

Question 1: From the following information, develop an AON project network. Complete the forward and backward pass, compute activity slack, and identify the critical path. How many days will the project take?
Question 2: You are tasked with planning and managing a software development project for creating a new mobile application. The project involves several phases and activities. Your task is to use any Project Management Software tool to create a Gantt Chart to visualize the project timeline and schedule. A screenshot of your Gannt Chart is needed. This screenshot must show the date and time from the task bar of your PC or Laptop.
The project consists of the following main activities and their durations:
Requirements Gathering: 5 days.
Design and Prototyping: 10 days.
Development: 20 days.
Testing and Quality Assurance: 15 days.
Deployment and Launch: 5 days.
Additional Information:
- The project must start on April 10, 2024. Include the start and end dates for each activity.
- Design and Prototyping cannot start until Requirements Gathering is complete.
- Development cannot start until Design and Prototyping is complete.
- Testing and Quality Assurance cannot start until Development is complete.
- Deployment and Launch cannot start until Testing and Quality Assurance is complete
